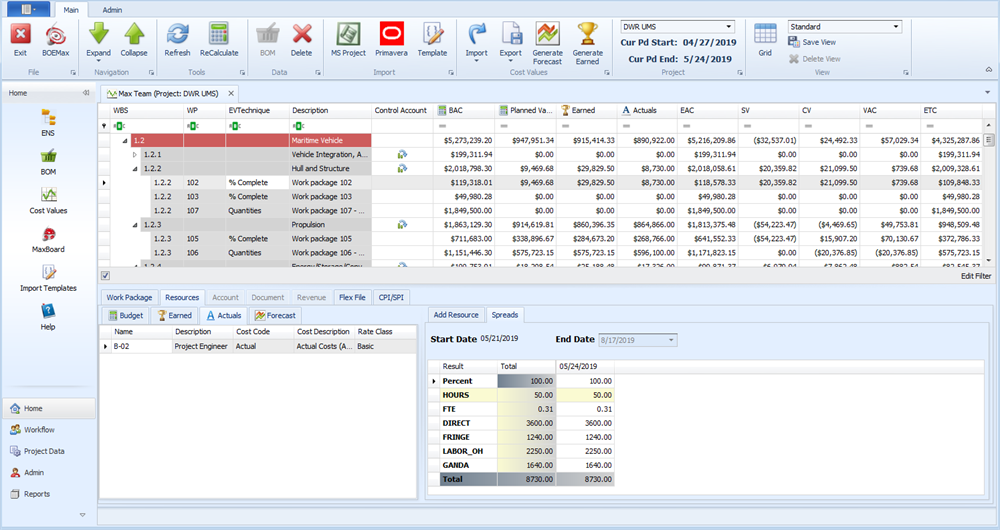

Actual Costs

As work is completed on the project, the actual costs incurred are typically recorded in an accounting system. For each reporting period, these actual costs incurred to do the work are imported into EVMax so they can be compared to the budget plan and work progress assessment. The cumulative to date actual costs are part of the equation to calculate the estimate at completion (EAC). Once work begins on the project, the actual costs replace the estimate to complete (ETC) values for the current reporting period. As a result, the EAC is updated every reporting period assuming you use the default calculation of EAC equals the cumulative to date actual costs plus the ETC. Comparing the budget at completion (BAC) to the EAC provides an indication whether the work will be completed under or over budget.

When needed, you can add a user defined cost code for estimated costs. Estimated costs are used in EVMax to represent the likely actual costs for material, purchased services, or purchased equipment where earned value has been claimed but invoices or billings have yet to be entered into the accounting system for the current reporting period. Estimated may be entered or imported from another system. The estimated cost values are replaced in EVMax with the recorded actual costs when they become available. Using estimated costs eliminates data validation issues where earned value is claimed and actual costs are missing.
